Backorders Without Broken Trust: A Recovery Plan for Small Product Businesses
Decide whether to hold, split, substitute, refund, or re-promise backordered orders using verified supply dates, customer choice, cost, and honest communication.
A backorder is not simply negative inventory. It is a promise that can no longer be executed as originally understood. The product, component, supplier, system count, or production window failed, and customers need choices based on verified information.
Small businesses often make the situation worse by giving an optimistic date, waiting for customers to ask, or shipping an unapproved substitute. The intention is to preserve the sale. The result can preserve revenue briefly while spending trust.
A recovery plan identifies affected orders, verifies the constraint, creates fair options, funds the remedies, and prevents new promises until availability becomes real.

The quick answer

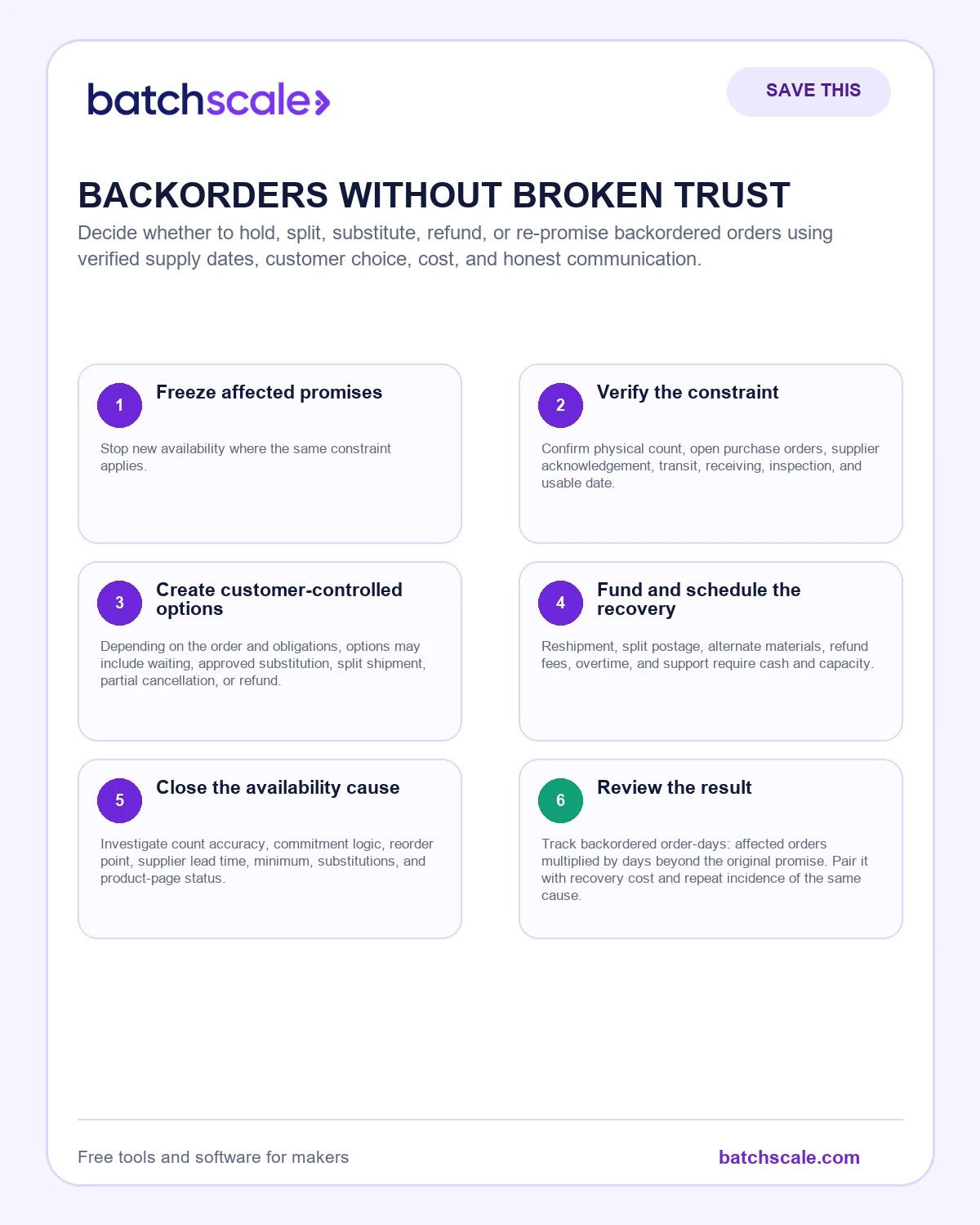

The outcome is a complete affected-order ledger, verified supply range, fair customer choices, funded recovery schedule, and corrected availability rule. Begin with Reconcile current physical, available, committed, work-in-progress, held, damaged, and inbound inventory for the affected product and every limiting component. The first operating priorities are freeze affected promises and verify the constraint; the working system then has to support create customer-controlled options, fund and schedule the recovery, close the availability cause. Keep the scope narrow enough that the decision can be tested with real evidence instead of debated through general opinions.
What this looks like in a real maker business
A body-care brand sells gift sets whose pumps are delayed. The supplier says “probably next week,” and the brand tells customers the same. Two missed dates later, support volume triples. The owner pauses new sales, confirms the earliest defensible date, offers wait, approved alternate closure, split shipment, or refund, and updates each order. The cost is visible; uncertainty stops spreading.

The practical playbook
Freeze affected promises
Stop new availability where the same constraint applies. Identify paid orders, drafts, wholesale allocations, replacements, and production that consume the missing item.
Put it to work: Create one affected-order list with promised date, customer need, payment, and current status.
Verify the constraint
Confirm physical count, open purchase orders, supplier acknowledgement, transit, receiving, inspection, and usable date. A supplier estimate is not the same as released stock.
Put it to work: Build the earliest, base, and delayed availability range from evidence.
Create customer-controlled options
Depending on the order and obligations, options may include waiting, approved substitution, split shipment, partial cancellation, or refund. State any price, timing, or specification difference.
Put it to work: Write choices in plain language without making the customer negotiate for a remedy.
Fund and schedule the recovery
Reshipment, split postage, alternate materials, refund fees, overtime, and support require cash and capacity. Protect unaffected orders from being silently displaced.
Put it to work: Calculate a promise date with the production promise planner.
Close the availability cause
Investigate count accuracy, commitment logic, reorder point, supplier lead time, minimum, substitutions, and product-page status. Update the system before reopening.
Put it to work: Require physical or confirmed usable availability before changing the listing back to in stock.
What can go wrong
Consumer, payment, preorder, delivery, cancellation, and platform requirements vary. Do not force store credit where a refund is required, hide delays, or substitute regulated or specification-sensitive components without valid review and customer agreement.
A useful safeguard is to keep the original source record beside the interpretation. If an order, count, supplier date, batch result, customer message, or payment changes, update the decision and preserve why it changed. This prevents a confident dashboard from drifting away from the physical business.
The number that keeps this honest
Track backordered order-days: affected orders multiplied by days beyond the original promise. Pair it with recovery cost and repeat incidence of the same cause.
Use the number as a decision signal, not a performance weapon. Review the definition, compare similar periods, and pair it with quality and customer evidence. A metric becomes dangerous when people improve the displayed result by moving work, cost, or failure outside the measurement.
A simple 30-day implementation
Week 1: establish the baseline
Gather the records described above and keep uncertainty visible. Use actual orders, batches, counts, supplier confirmations, and payment records wherever possible. Mark estimates instead of polishing them into false facts. Choose one product, channel, or workflow narrow enough to finish in a week. A completed small baseline teaches more than a company-wide workbook nobody trusts.
Week 2: change one operating rule
Translate the first two playbook steps into a rule with an owner, trigger, input, decision, and expected output. Save the previous method. Explain the change to everyone whose work or promise is affected. If the rule touches safety, compliance, employment, tax, contracts, or regulated claims, pause for qualified guidance before using a general article as authority.
Week 3: run the rule in real work
Use the rule through a normal cycle. Record exceptions when they happen; do not repair the record after the fact. Keep customer commitments and required controls intact. One exception may be ordinary variation. Repeated exceptions usually mean the threshold, instruction, source data, authority, or capacity assumption needs revision.
Week 4: review the evidence
Compare the baseline with the metric in this guide. Ask what improved, what moved somewhere else, and what new burden appeared. Keep the rule, revise it, or remove it. Write the decision, owner, and next review date. That short history becomes operating memory and prevents the same debate from restarting whenever the founder is tired.
When connected software becomes useful
Spreadsheets and checklists are excellent for learning a method. They become fragile when the same product, formula, material, batch, order, customer, and cost must be updated in several places. Duplicate entry creates version disagreement; delayed entry makes reports look precise while the floor works from different facts.
Connected software should not automate confusion. It should preserve the current product version, show available and committed inventory, connect production with actual material and yield, carry costs into channel decisions, record who changed what, and make exceptions visible. Start with the decision that currently requires the most reconciliation. Add the next workflow only after the first source of truth is dependable.
Questions to ask before you scale the change
- Can a trained person explain the rule and the reason behind it?
- Is the required source data available at the moment the decision is made?
- Does the rule protect product quality, customer expectations, and applicable obligations?
- What evidence would prove the change is helping rather than moving cost elsewhere?
- Who owns an exception, and how quickly must they respond?
- Can the business export the records and reconstruct what happened later?
Growth becomes calmer when decisions leave a trail. The objective is not more administration. It is fewer avoidable surprises and a business that can repeat what works.
Related tools and reading
The bottom line
The outcome is a complete affected-order ledger, verified supply range, fair customer choices, funded recovery schedule, and corrected availability rule. Choose one product or workflow, establish the baseline, and make one observable change. Review the result after a real cycle. Clear evidence, a responsible owner, and a next review date will outperform a dramatic overhaul that the business cannot sustain.
