Operations & Growth
The 80% Capacity Rule: Why Fully Booked Is Already Late
Use a practical planning ceiling to protect normal variation, quality, maintenance, communication, and recovery before the schedule breaks.
A calendar booked to one hundred percent assumes every supplier arrives on time, every batch reaches perfect yield, every tool works, every approval returns promptly, nobody becomes ill, and no customer needs help. In other words, it assumes a different business.

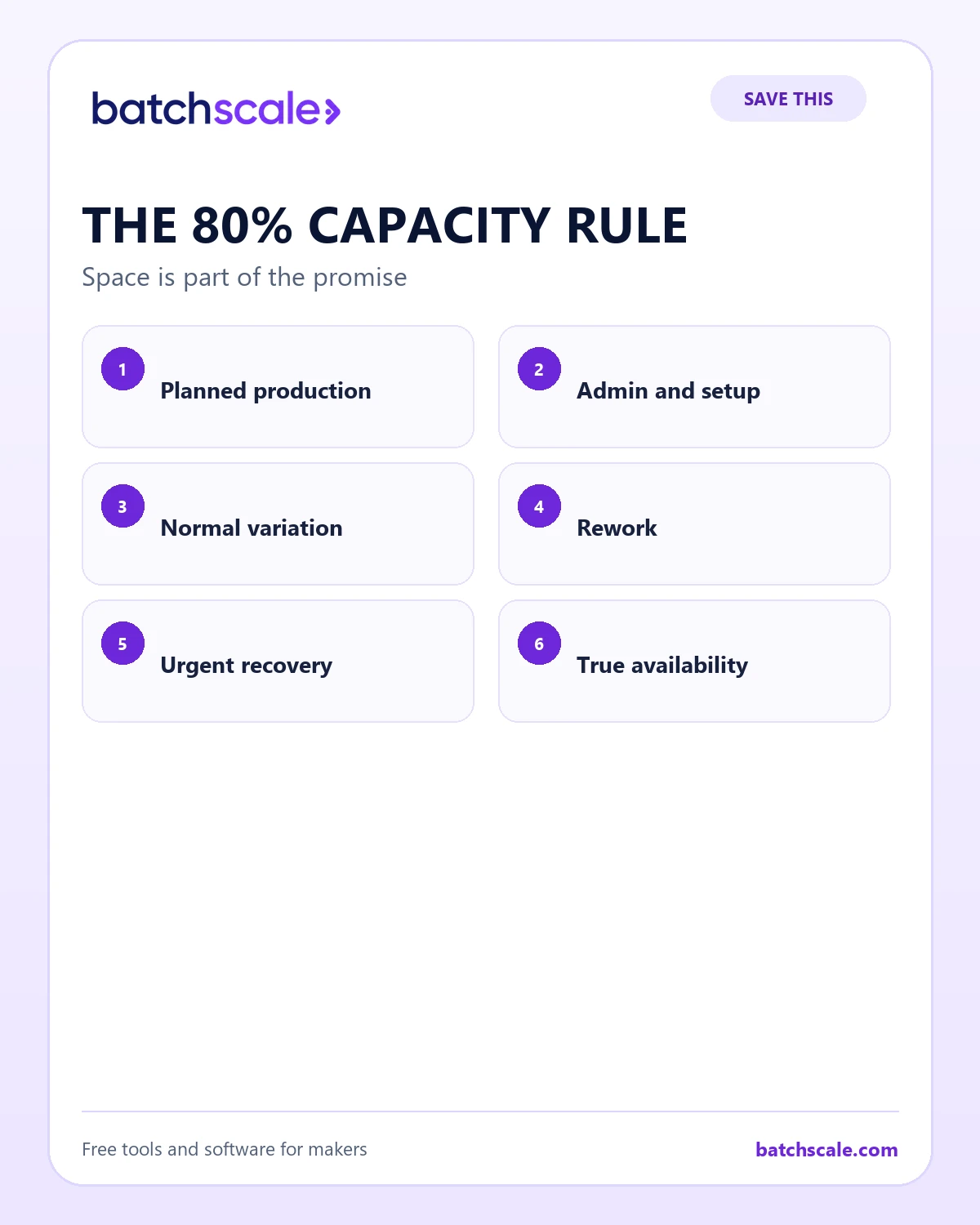

The 80% rule is a planning heuristic: commit roughly four-fifths of practical capacity and preserve the remainder for normal variation, rework, maintenance, customer communication, and recovery. It is not a universal scientific constant. Some stable processes can plan higher; high-variation custom work may require more space. Its value is forcing the business to acknowledge that variability consumes time even when the calendar does not display it.
Empty capacity is not always waste. Sometimes it is the inventory that protects on-time delivery.

The real-world pattern
A custom bakery has forty available production hours and sells forty. The owner forgets five hours of administration, three of cleaning and setup, and the normal two-hour weekly rework load. By Thursday, the schedule is ten hours late before anything unusual happens. Planning from thirty-two practical hours, improving setup, and charging rush requests for the capacity they displace restores reliable pickup windows.

The practical playbook
Calculate practical capacity
Begin with staffed or founder hours, then subtract planned administration, meetings, breaks, cleaning, maintenance, setup, and nonproduction duties. The remainder is not theoretical machine speed.
Put it to work: Use the labor-capacity calculator with observed standard times and normal product mix.
Measure normal variation
Track delay, rework, supplier interruption, equipment adjustment, and customer clarification over several cycles. Buffer should reflect real uncertainty.
Put it to work: Separate recurring work disguised as surprise from genuinely unusual events; schedule recurring work explicitly.
Place capacity at the constraint
Extra packing time does not rescue an overloaded oven, kiln, filling station, curing rack, or founder-only approval. Plan the narrowest required resource.
Put it to work: Express demand in constrained minutes per product, including setup and expected first-pass yield.
Create a rule for the reserve
Unprotected space will be sold casually. Define which recovery, high-value rush, safety, maintenance, or strategic work can consume it and who approves that choice.
Put it to work: Record buffer use for a month. Frequent consumption by one cause signals a process problem, not bad luck.
Raise the ceiling with evidence
Improve changeover, standard work, maintenance, training, or product mix, then confirm on-time quality before committing the recovered hours.
Put it to work: Do not sell modeled gains before representative cycles prove they are real.
What to watch
A percentage cannot replace risk analysis. Perishable, safety-critical, regulated, long-cure, and highly custom processes need category-specific planning. Never use the reserve to conceal chronic understaffing or unsafe pace.
The number that keeps this honest
Track committed load as a percentage of practical constrained capacity beside on-time completion and overtime. The right planning ceiling is the highest level that preserves delivery, quality, and sustainable work.
Put the lesson to work without rebuilding everything
Choose one current product and one recent operating cycle. Gather the source evidence before changing the system: purchase records, actual material quantities, sellable yield, hands-on time, order history, refunds, defects, customer questions, and the cash that moved. Estimates are acceptable when clearly labeled, but replace the highest-impact estimate first. A small maker does not need perfect data; the business needs numbers reliable enough to support the next decision.
Write the decision in plain language. “Improve inventory” is a project with no finish line. “Set a reorder trigger for the vessel that can stop our bestseller before Friday” can be completed and tested. Name the product, owner, trigger, action, and review date. Use a checklist or spreadsheet if that is sufficient. Add software only when the same information must stay connected across orders, materials, formulas, production, purchasing, and more than one person.
Run a seven-day evidence sprint
On day one, document the current method without defending it. On day two, calculate the baseline result. On day three, identify the earliest point where information becomes uncertain or work begins to wait. On days four and five, make the smallest useful control: a specification, decision rule, capacity limit, cost field, status, template, or quality check. On day six, run it through a real order or representative batch. On day seven, compare the result and decide whether to keep, revise, or remove the control.
The sprint should answer one question, not digitize the company. Record unintended consequences. A faster packout that increases damage is not an improvement. A lower material price that demands too much cash or produces inconsistent batches is not automatically a saving. A popular offer that requires unpaid founder labor is not automatically a winner. Look at the entire promise from purchasing through customer acceptance.
Keep a decision-grade scorecard
Most topics in this guide can be monitored with a short weekly scorecard:
- demand: qualified inquiries, orders, units, conversion, and repeat behavior;
- economics: net revenue, sellable unit cost, contribution, and contribution per constrained hour;
- delivery: promised versus actual completion and the age of open work;
- quality: first-pass yield, defects, rework, replacements, and the reason for each exception;
- inventory: available, committed, held, incoming, and days of practical coverage;
- cash: money committed before delivery, expected receipts, and obligations that are not spendable profit.
Not every business needs every measure. Choose the few that can change an action this week. Define each measure so the number cannot quietly change meaning. Compare normal cycles rather than a launch-day peak with a quiet Tuesday. Trends become useful only when the underlying definitions remain stable.
Build a rule for the tired version of you
A useful operating rule still works when the founder is busy. Write it as an if-then statement: if available stock reaches the reorder point, create the purchase decision; if requested customization exceeds the included revision, pause and re-quote; if practical capacity exceeds the agreed threshold, offer a later window; if a critical quality check fails, hold the affected work and investigate before release.
Test the rule against a recent surprise. Would it have prevented the late order, weak margin, shortage, or confusing customer exchange? If not, make the trigger more specific. If it creates ceremony around low-risk work, make it lighter. Good systems are not collections of forms. They make the correct action easier to recognize at the moment it matters.
Know when the system is ready to grow
Expansion should be earned by evidence: repeated full-price demand, a complete cost that pays sustainable labor, stable quality, a funded replenishment cycle, and a process that does not require emergency intervention every time. Before adding products, channels, equipment, or staff, name the constraint the investment will relieve and the result that will prove it worked.
Also define a stop or revision rule. Decide the maximum cash, time, defect rate, or delivery risk you will accept before pausing. This does not make the business less ambitious. It protects the resources required for the next good experiment. A clear no is often the system that preserves a better yes.
Questions for the next operating review
Before closing the review, ask whether the current offer and the current process describe the same promise. Marketing may still show an old package, quantity, lead time, option, or result after production has changed. Purchasing may use a new component that has not reached the specification. A customer-service reply may create an exception the schedule never received. Walk one recent order from the page the customer saw through the materials, batch, inspection, packout, delivery, and payment. Correct the earliest mismatch rather than adding another downstream reminder.
Then test the decision under three conditions: normal demand, a credible peak, and a disruption. The peak is not an imaginary viral month; it is the largest scenario supported by an event, wholesale conversation, seasonal history, preorder count, or campaign plan. The disruption should reflect a real vulnerability such as a long-lead package, unavailable founder skill, lower yield, carrier delay, or rejected material. Decide in advance which quantity, date, substitute, allocation, or communication rule changes in each condition.
Finally, review the human load. Count the steps that require memory, private messages, repeated copying, after-hours rescue, or one person's approval. Decide which should be removed, standardized, delegated, or made visible. Do not automate an unsafe or unclear decision merely because it repeats. Establish the rule and evidence first, then use automation to carry reliable information between steps.
Before the next cycle begins, make the change observable. Save the old baseline, the new rule, the person responsible, and the date when the team will review the outcome. Tell affected customers or partners when the change alters a promise, lead time, quantity, specification, or price. During the cycle, capture exceptions without treating every exception as a reason to abandon the rule. At review time, separate normal variation from a recurring failure. Keep the change when it improves the intended result without moving unacceptable cost or risk somewhere else. Revise it when the direction is right but the trigger, threshold, or instruction is weak. Remove it when it adds work without improving a decision. This simple record creates a reusable operating memory and gives future teammates the reason behind the process, not only the latest version of a checklist.
The review is complete when it produces an owner, action, and date. Keep a short record of the decision and the result after the next cycle. That history prevents the business from reopening the same debate every month and turns ordinary operations into a durable body of knowledge. Share the rule with everyone affected, confirm that they can follow it with the information available, and revise any instruction that depends on unspoken founder knowledge.
The bottom line
The purpose of operations is not to make a small business feel corporate. It is to protect the product, the customer, the cash, and the people doing the work. Choose one action from this guide, assign it to a real product and date, and review the evidence after the next cycle. Consistent learning compounds faster than dramatic reinvention.
